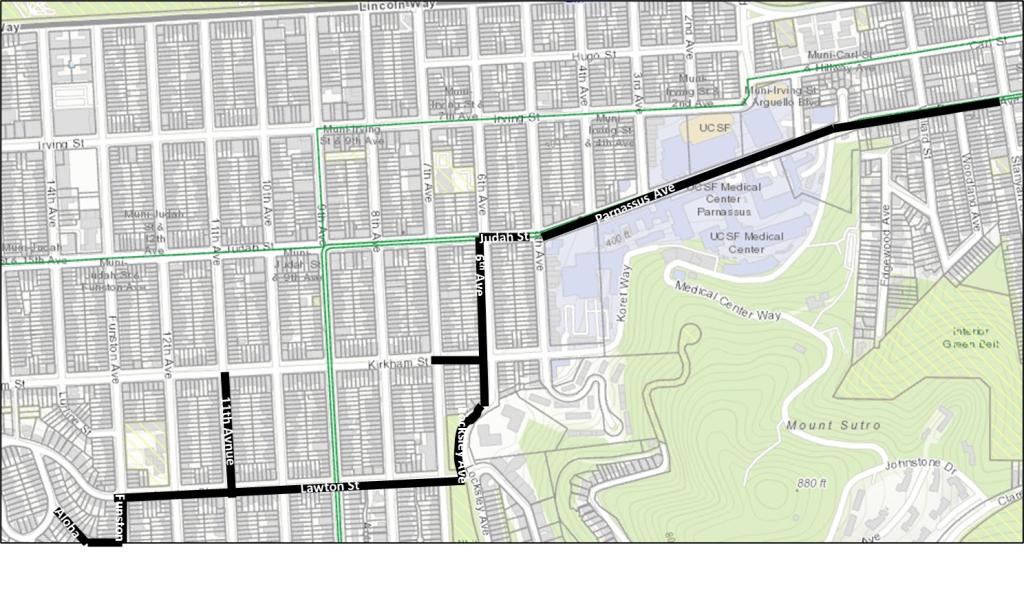

Week of Sept. 8-12 -- Install new 12" main on Lawton St.; dig tie-in hole at Stanyan St. & Parnassus Ave. intersection; dig hydrant removal pits; cover and compact trench on Parnassus Ave. fronting UCSF hospital, and from 3rd to 4th Ave.; grind and pave 11th Ave. from Kirkham St. to Lawton St. and 11th Ave./Kirkham St. intersection.
Week of Sept. 15-19 -- Install new 12" main on Lawton St. and on Funston St. & Aloha St.; t-trench from 6th Ave. to 4th Ave.
Week of Sept. 22-26 -- Install new 12" main on Funston St. and Aloha St.
What to expect during construction
- Work on your block will not be continuous. Expect crews to finish a portion of work and return at a later date (sometimes months later) to perform a different aspect of work.
- You will have access to your driveway and garage throughout the project, although there may be a slight delay if equipment or steel plates need to be moved to facilitate entry/exit.
- There will be no parking signs placed throughout the project. Please pay attention to the details posted on the signs. Generally, no parking applies during work hours. Some parking may be designated as "staging areas" for storing equipment and materials.
- At the end of each workday, the contractor will place temporary paving or steel plates for public access.
- When a major portion of the project is completed -- or the whole project is done -- the contractor will arrange for "final" paving, followed by striping of lanes and other traffic markings.
