East SOMA Sewer Improvements Project

Overview

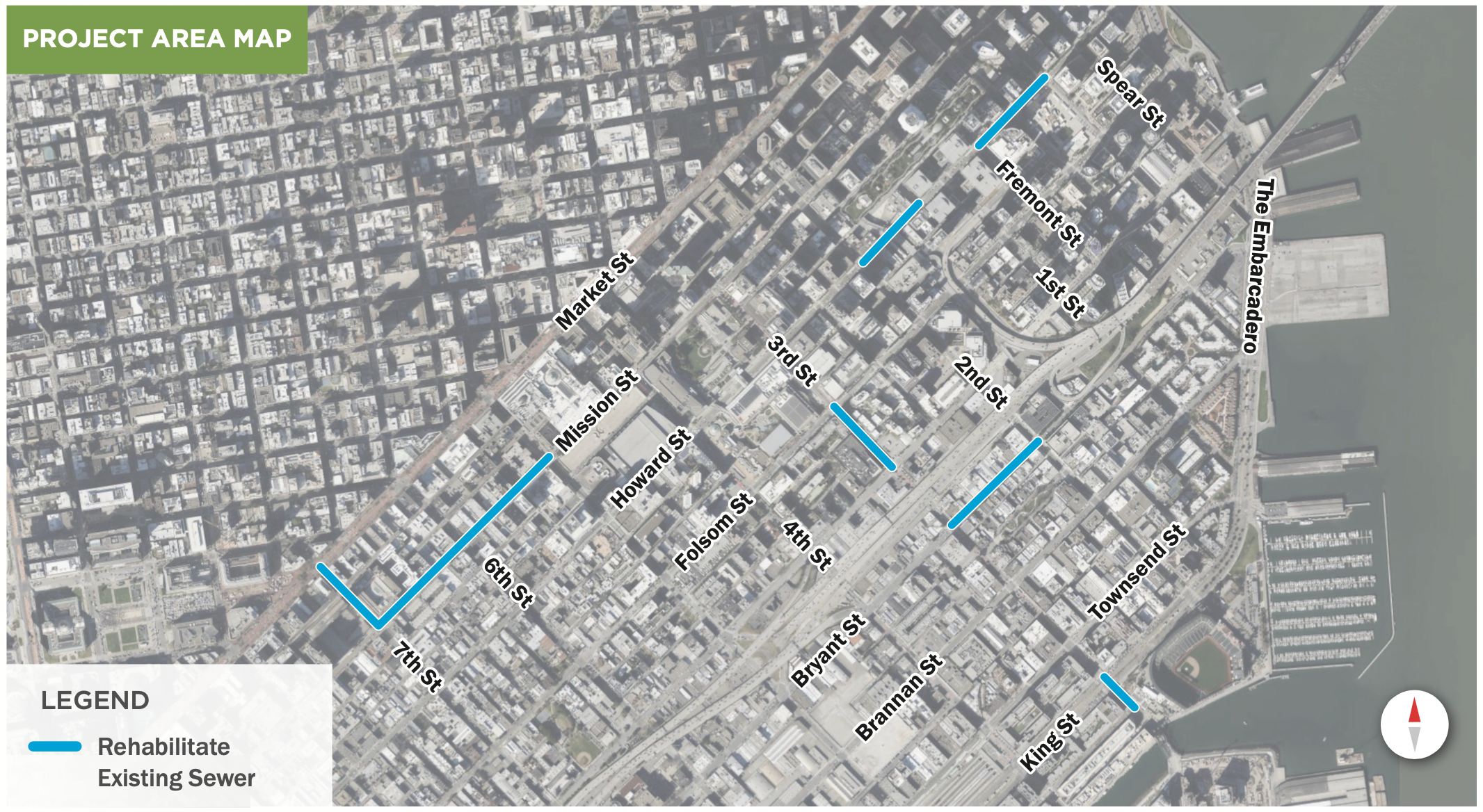

The East SOMA Sewer Improvements Project will rehabilitate the existing 100-year-old sewer mains and sewer lower laterals located under several streets highlighted on the Project Maps.

Please check this project page for timely updates about the construction schedule and upcoming locations. To receive these updates via email, please complete the form on the right-hand side of this page.

1-week Look-ahead Construction Summary*
*Please note Schedule is subject to change.

Mission Street (7th Street and 6th Street)

  • June 9: Backfill and restore streetbase for two sewer manholes
  • June 9: Re-mobilize to perform the de-energization of the OCS
  • June 10 – 13: Complete AC paving for the sewer manholes, laterals, and culverts
  • June 13: Perform final re-energization of the OCS

Mission Street (6th Street and 5th Street)

  • June 10 – 13: Complete AC paving for the sewer manholes, laterals, and culverts

7th Street (Mission Street and Market Street)

  • June 9 – 10: Excavate and replace sewer lateral
  • June 9 – 10: Demo and replace concrete parking strip
  • June 12 – 13: Perform initial cleaning and CCTV inspection of sewer main for lining
  • June 14 – 15: Perform additional sewer culvert lining

3rd Street (Folsom Street and Harrison Street)

  • June 6 – 8: Perform sewer main lining
  • June 9 – 10: Backfill and restore streetbase for the sewer manhole
  • June 9 – 10: Demo and replace concrete parking strip
  • June 9 – 10: Replace streetbase for additional sewer culvert
  • June 9 – 10: Replace streetbase for additional sewer lateral

Howard Street (Fremont Street and Main Street)

  • June 11-13: Excavate and replace additional sewer laterals
  • June 14 – 15: Perform initial cleaning and CCTV inspection of sewer main for lining
  • June 15 – 20: Perform sewer main lining

Schedule Subject to Change, last updated on 06/10/2025. Have questions? Please reach out to us by email at ssip@sfwater.org with 'East SOMA' in the subject line.

  • Construction Start: Late 2024
  • Construction End: Late 2025
  • Project Phase: Construction
